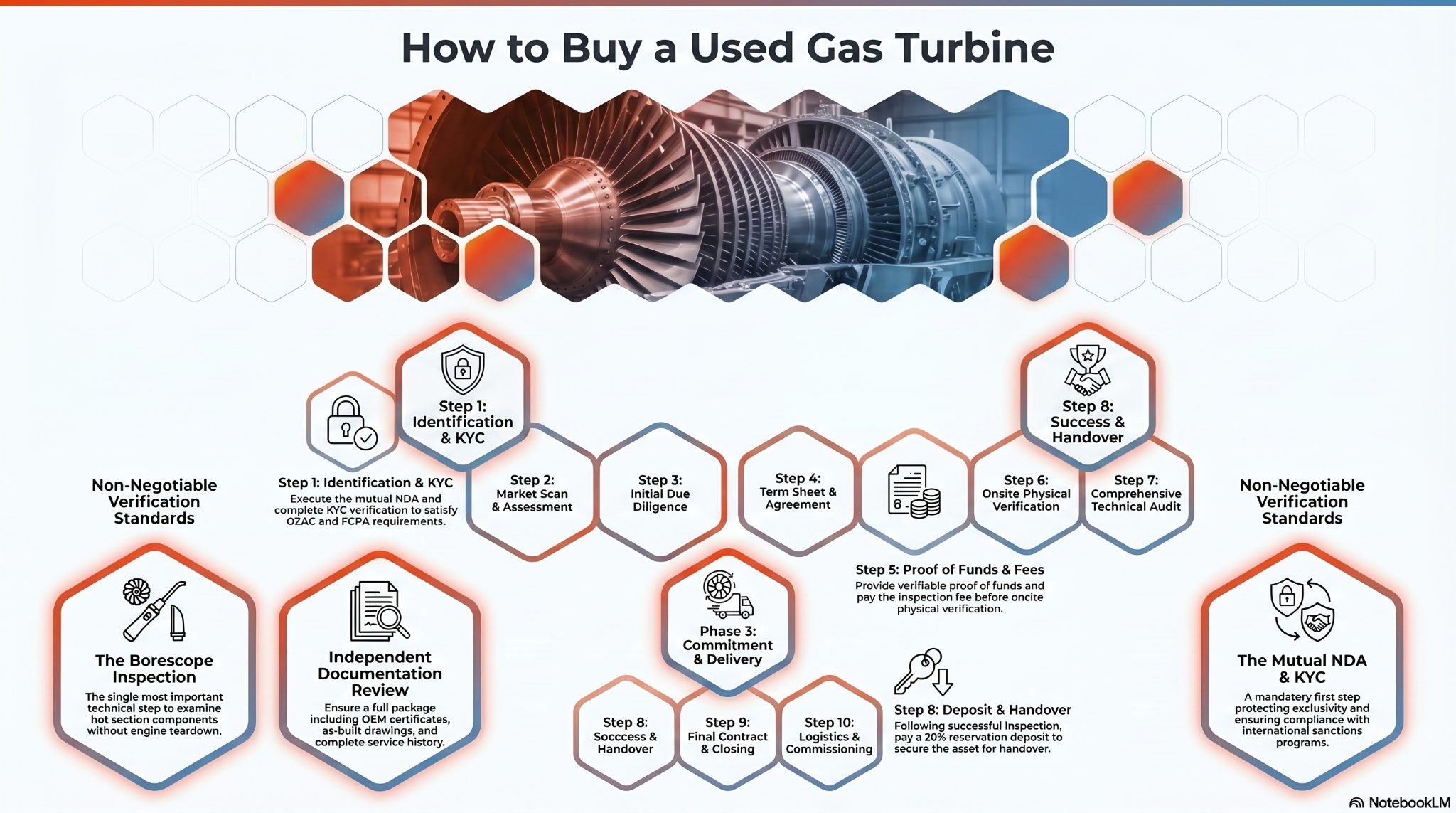

How to Buy a Used Gas Turbine: A Neutral Guide to Inspection, Documents, Compliance and Payment
How to buy a used gas turbine is a question every owner, developer and EPC contractor faces when new equipment is too slow or too expensive. A used machine can bring power online sooner, but only if its condition, history, paperwork and legal status are verified before money moves. This guide sets out the steps a careful buyer follows, from defining the need to inspection, compliance screening, contract terms and shipping. It is general information. It does not describe any specific unit, price or availability, and every claim made by a seller should be confirmed in writing and by an independent inspector.
Start With the Duty, Not the Machine
The first step in how to buy a used gas turbine is to define what the machine must do. Write down the required output at site conditions, the fuel and its quality, the duty cycle, the emissions limits, the grid or island connection and the schedule. A turbine rated for a cool sea level site will deliver less in a hot, high altitude location, so ratings must be corrected for the real ambient conditions. Decide whether the plant will run as baseload, peaking or standby power, because a machine with many starts may carry different wear from one that ran continuously.
Next, decide the technology family. Aeroderivative turbines are light, start quickly and suit mobile or fast track plants. Heavy frame turbines are larger, suit continuous duty and often form the core of combined cycle plants. Industrial two shaft machines sit between them. The U.S. Energy Information Administration explains how electricity is generated and how natural gas is used for power, which gives useful background before a technical discussion with sellers.
Why the Used Gas Turbine Market Needs a Structured Process
The used market ranges from original equipment manufacturers and credentialled contractors with full documentation, to brokers who have never seen the asset, to parties who offer equipment they do not control. The price of a mistake is high, because a turbine is expensive and slow to replace. A structured process protects the buyer by separating claims from evidence. Each step below asks for evidence that can be checked.
Three questions help with every offer. Who owns the asset, and can they prove it? Where is the asset, and can an independent party inspect it? What documents travel with it? If a seller cannot answer clearly, the buyer should pause. A buyer should never rely on photographs, brochures or verbal statements alone.
The Used Gas Turbine Inspection Checklist
How to buy a used gas turbine safely depends on an independent inspection by a competent party. The table lists the main areas to cover. Scope should be agreed in writing before the inspector travels.
|
Inspection area |
What to check |
Evidence to request |
|
Operating history |
Running hours, starts and trips |
Hour and start counters, control system logs |
|
Maintenance history |
Inspections, overhauls and repairs |
Work orders, service reports and parts records |
|
Hot section |
Combustion liners, nozzles and turbine blades |
Borescope images and written findings |
|
Compressor |
Blade erosion, fouling and clearances |
Inspection report and trend data |
|
Rotating assembly |
Bearings, vibration history and alignment |
Vibration records and bearing inspection notes |
|
Generator |
Insulation condition, rotor and stator state |
Electrical test results |
|
Controls |
Software version, licences and obsolescence |
Control system documentation |
|
Auxiliaries |
Fuel system, starting system and enclosure |
Condition notes and photographs |
|
Documentation |
Data books, drawings and test records |
Complete document package |
A borescope inspection looks inside the machine without full disassembly and is a common first step. It does not replace a full teardown, and it cannot see everything. The buyer should ask the inspector to state what was and was not examined, and to give an opinion on remaining life of key parts. Be wary of reports that give only a pass or fail.
Records That Matter Most
Records are often worth as much as the hardware. A used turbine without hour counts, repair history and original data books is harder to insure, finance and maintain. Ask for the following:
- Original equipment data book and performance test records.
- Maintenance history, including any major inspections and part replacements.
- Records of repairs, including who carried them out and with what parts.
- Control system software and licence status.
- Export, import and customs documents where the machine has crossed borders.
- Proof of ownership and freedom from liens.
Ownership, Title and Liens
Before any deposit, confirm that the seller can lawfully sell the asset. Request proof of title, such as purchase contracts or registration, and confirm there are no liens, leases or finance claims. A short search by a lawyer in the jurisdiction where the asset sits is inexpensive compared with the cost of a disputed title. If the seller is an intermediary, ask for written confirmation of its authority to sell and for the identity of the owner once a confidentiality agreement is signed.
Confidentiality Agreements and Know Your Customer Checks
Sellers often ask for a mutual non disclosure agreement before sharing location and technical data. This is normal and reasonable. It protects commercial relationships and prevents a buyer from bypassing the seller to contact the owner. Read the agreement carefully, including any clause on introducing parties, fees or circumvention, and take legal advice on its terms before signing.
Know your customer checks are also normal. Responsible parties verify who is buying, where the equipment will be used and how it will be funded. This protects both sides and is required by law in many places. A buyer who is unwilling to explain the end user or the source of funds should expect questions and may find that reputable sellers decline to proceed.
Sanctions, Export Controls and Anti Corruption Law
Gas turbines are controlled goods in many jurisdictions. Depending on the origin of the equipment, the parties and the destination, a sale can be affected by sanctions, export controls and anti corruption law. The U.S. Treasury’s Office of Foreign Assets Control publishes sanctions programmes and lists at OFAC. The U.S. Department of Commerce publishes the Export Administration Regulations. The U.S. Department of Justice explains the Foreign Corrupt Practices Act. Other countries and the European Union and United Kingdom have their own regimes, which can differ.
Practical consequences are clear. Confirm the origin and any prior export licences of the machine. Confirm that neither party, nor the end user, nor the destination is subject to restrictions that apply to the transaction. Never agree to hide the end destination, route equipment through a third country to avoid a rule, or pay commissions to officials. Where there is doubt, take advice from a qualified sanctions and export controls lawyer before signing. This section is general information and not legal advice.
Price, Deposits and Payment Protection
Price depends on model, size, age, condition, hours, location and what is included. Compare offers on the same basis: ex works or delivered, with or without a generator, controls, enclosure, auxiliaries, spares and documents. Ask what is not included. A low headline price often leaves out items that the buyer must then buy separately.
Deposits need care. Never pay a deposit before the identity and title of the seller are verified and a written agreement is in place. Consider payment through an escrow arrangement or a documentary letter of credit, where a bank or escrow agent releases funds against agreed documents or milestones. Make deposits refundable if the asset is materially not as described, and define who decides and how. Keep records of every payment and its purpose. Avoid sellers who insist on urgent payments to personal accounts or who refuse bank based protections.
Contract Terms to Agree
A purchase contract should state clearly the asset identity, serial numbers, scope of supply, condition at handover, inspection rights, payment terms, delivery terms, title transfer, risk transfer and remedies. It should define what happens if the asset is not as represented, how disputes are resolved and which law applies. Ask whether any warranty is offered, how long it lasts and what it covers. Used machines are often supplied as is, which makes the inspection and the description in the contract more important.
Insurance for transport and installation should be arranged before the machine moves. Where the machine is financed, the lender will have its own technical and legal requirements, which should be understood at the start.
Dismantling, Packing, Shipping and Customs
Dismantling and packing are technical tasks. A turbine must be preserved and packed correctly so that bearings, seals and electrical parts are not damaged in transit. Ask who is responsible, what standard applies and how condition at loading will be recorded. Shipping terms should state who arranges transport, who pays for insurance and where risk passes. Customs and import duties differ by country, so check them early. Delays at ports can add weeks to a schedule and are a common source of cost overruns.
Installation, Commissioning and Performance
A used turbine is only part of a power plant. The project also needs foundations, fuel supply, inlet and exhaust systems, cooling, switchgear, controls, grid connection and permits. These items are often called balance of plant, and they can account for much of the total installed cost. Plan their design and procurement alongside the purchase of the machine, so that the equipment is not delayed on site.
Commissioning should include functional tests and a performance test against agreed criteria. If a conversion is needed, such as a change in fuel or in frequency, involve engineers early. Emissions limits for the site should be checked before purchase, because older machines may need upgrades to comply.
Financing, Insurance and Residual Value
Lenders and insurers may ask for the inspection report, the title documents, the maintenance plan and the operator’s experience. A used machine with a clear history is easier to finance than one with gaps. Residual value depends on market demand, remaining life and parts availability, so ask whether the model is still supported by its manufacturer or by independent service providers. Obsolete controls can raise long term maintenance cost.
Common Mistakes When Buying a Used Gas Turbine
- Paying a deposit before verifying the seller, the asset and the title.
- Relying on photographs or brochures instead of an independent inspection.
- Accepting a pass or fail report without a clear scope.
- Ignoring missing records, data books and control system licences.
- Comparing prices without checking what is included.
- Underestimating balance of plant, permitting and grid connection.
- Overlooking sanctions, export controls and anti corruption rules.
- Forgetting dismantling, packing, shipping and customs time.
- Agreeing weak remedies if the asset is not as described.
- Failing to plan operations and maintenance support after commissioning.
Compliance and Approved Case Studies
USP&E screens transactions against sanctions and anti-corruption rules, and it describes its approach on its integrity and compliance page. Any buyer or seller should confirm the parties, the end use and the source of funds before equipment is committed.
USP&E only publishes approved case studies, and it does not name clients without permission. USP&E has delivered projects in 45+ countries, including power plant EPC projects and operations and maintenance work, and approved examples are collected on the case studies page. No outcome specific to how to buy a used gas turbine is claimed here beyond what is published. Equipment offered by USP&E is described only in its published inventory pages, and any specific unit must be confirmed at enquiry.
Ten Criteria for Choosing a Used Gas Turbine Supplier
- Proof of title. The seller can show ownership and freedom from liens.
- Independent inspection. The buyer can appoint an accredited inspector.
- Complete records. Data books, history and software licences are supplied.
- Clear scope. The contract lists exactly what is included.
- Fair deposit terms. Deposits are protected and refundable if the asset is materially not as described.
- Compliance process. The seller screens parties and follows applicable law.
- Technical support. The seller can support installation and commissioning.
- Spare parts plan. Parts and service support are available for the model.
- Honest commitments. The seller promises only what it can support.
- Transparent communication. Questions are answered in writing.
Key Takeaways on How to Buy a Used Gas Turbine
- Define the duty, site conditions and fuel before looking at machines.
- Insist on an independent inspection with a written scope and report.
- Verify title, records and the identity of the seller before paying a deposit.
- Check sanctions, export controls and anti corruption rules for every transaction.
- Protect payments with escrow or a letter of credit and agree clear remedies.
- Plan balance of plant, permits, shipping and commissioning from the start.
Frequently Asked Questions About How to Buy a Used Gas Turbine
What is the first step in how to buy a used gas turbine?
Define the duty: output at site conditions, fuel, duty cycle, emissions limits, grid connection and schedule. With that written down, you can compare machines on a like for like basis and ask sellers focused questions. Without it, price comparisons are misleading and the wrong model may be bought.
Should I inspect a used gas turbine before paying a deposit?
Yes, where possible. An independent inspection by an accredited party, with a scope agreed in writing, is a strong protection against undisclosed condition. If an inspection cannot happen before a deposit, the deposit should be protected by escrow or other bank based terms and be refundable if the asset is materially not as described.
What documents should come with a used gas turbine?
Ask for the original data book, performance test records, maintenance and repair history, control system software and licence status, import and export papers, and proof of ownership. Missing records do not always mean a bad machine, but they raise risk, insurance cost and future maintenance difficulty.
How do sanctions and export controls affect a used turbine purchase?
They can restrict who may buy or sell a machine, where it may go and what licences are needed. Check the origin of the equipment, the parties and the destination against the rules of every jurisdiction involved. Take advice from a qualified lawyer. This is general information and not legal advice.
Is a borescope inspection enough?
A borescope inspection is a useful first look at the hot section and compressor, but it cannot see everything. For a major purchase, many buyers add vibration records, generator electrical tests, a review of operating data and, where justified, a more detailed inspection. Ask the inspector to state what was not examined.
How should payment be structured?
Use protected payment terms where possible, such as an escrow arrangement or a documentary letter of credit, with funds released against agreed milestones or documents. Keep deposits modest until title and condition are verified, make refund conditions clear, and avoid paying to personal accounts or on urgent demand.
How can I ask USP&E about equipment?
Share your required output, fuel, site location, schedule and compliance details, and USP&E’s engineers can discuss options. Availability, price and terms are confirmed in writing for each enquiry, and no unit is promised until the checks described above are complete.
