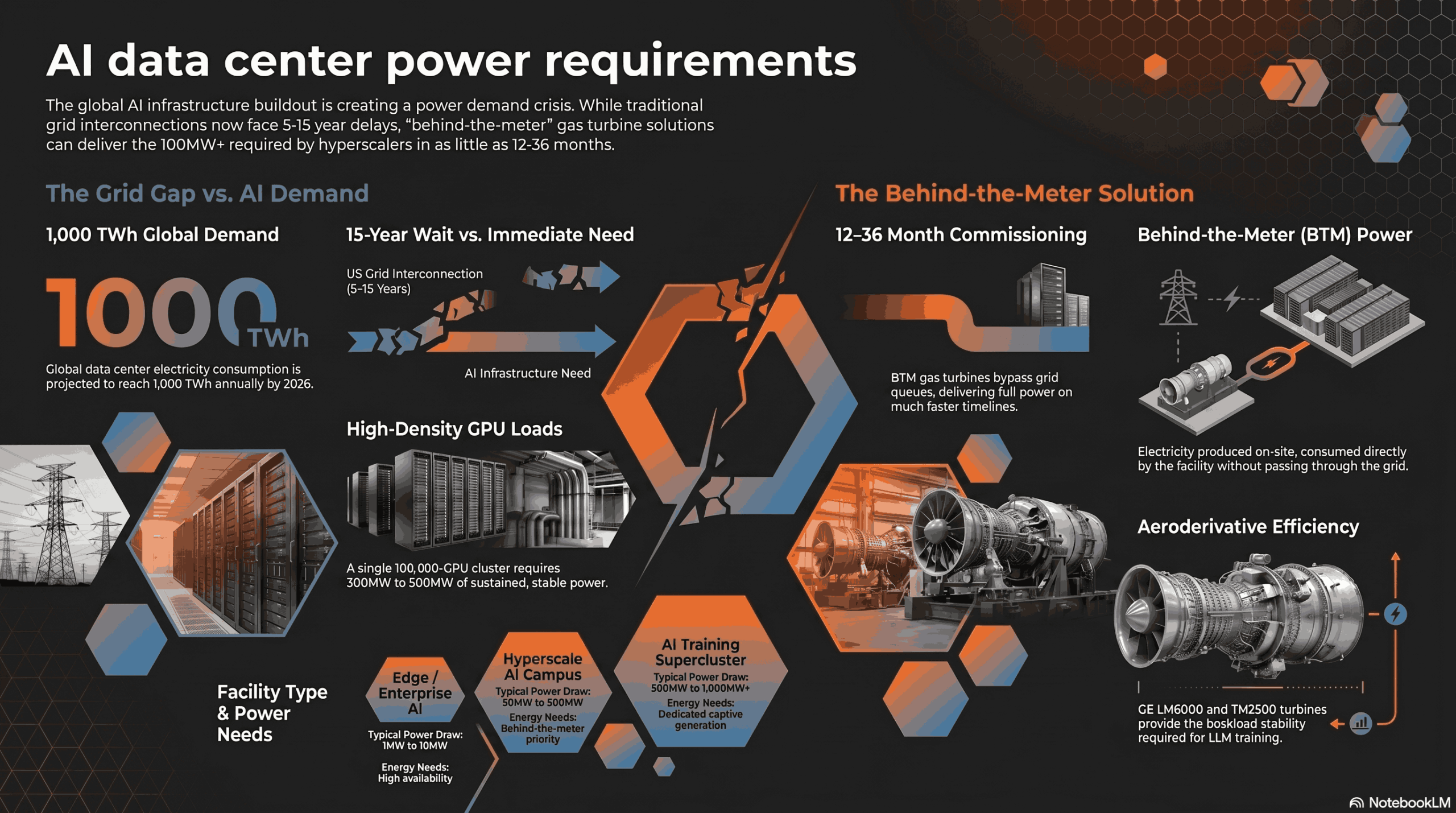

Data Center Power Requirements for AI and Hyperscale Campuses
Data center power requirements are the electrical load a data hall or AI campus needs for IT equipment, cooling and redundancy. A small enterprise AI site may need 1 MW to 10 MW; mid-scale colocation often sits at 10 MW to 50 MW; hyperscale AI campuses commonly plan 50 MW to 500 MW or more. Behind-the-meter gas turbines meet that load when the grid queue is too slow.
The challenge is not simply one of scale. It is one of speed, reliability, and fuel flexibility. Traditional grid connection timelines in the United States range from 5 to 15 years for new high-voltage interconnection approvals. The hyperscaler pipeline cannot wait. Bitcoin mining operations, AI training campuses, and colocation facilities serving the world’s largest technology companies are turning to behind-the-meter gas turbine power generation, fast-track EPC contractors, and hybrid power systems to meet demand on their own timelines.
This guide covers everything decision-makers need to understand about AI data center power requirements: how much power AI workloads actually consume, how to size a captive power plant for a hyperscale facility, what fuel types are viable, and what EPC procurement criteria separate projects that commission on schedule from those that stall for years.
USP&E has supported data center, bitcoin mining, and industrial power projects across North America, the Middle East, and Africa for 24+ years. Our full complement of mechanical, electrical, process control and implementation engineers has built and operated power stations in 45+ countries with active projects in the United States, Saudi Arabia, Togo, Mali, and Liberia. Explore our data center and AI gas turbine power solutions for a full overview of our capabilities.
AI Power Requirements per Rack: From kW per Rack to MW per Campus
AI power requirements start at the rack. An air-cooled enterprise rack typically draws under 10 kW, while liquid-cooled GPU racks for AI training are designed for up to about 132 kW. To size a campus, multiply kW per rack by the rack count, convert to MW, then multiply by PUE for cooling and losses, and add redundancy.
MW per rack count at published rack densities (illustrative arithmetic, not a USP&E design figure)
| Rack profile | kW per rack (source) | IT load per 100 racks | IT load per 1,000 racks | Facility load per 1,000 racks at PUE 1.2 | Facility load per 1,000 racks at PUE 1.56 |
|---|---|---|---|---|---|
| Typical enterprise / colocation rack | about 8 kW, the 2024 survey average (Uptime Institute) | 0.8 MW | 8 MW | 9.6 MW | 12.5 MW |
| High-density air-cooled rack | 30 kW, the level most facilities do not yet exceed (Uptime Institute) | 3 MW | 30 MW | 36 MW | 46.8 MW |
| Liquid-cooled AI rack (NVIDIA GB200 NVL72 class) | up to 132 kW per rack (Vertiv / NVIDIA reference architecture) | 13.2 MW | 132 MW | 158.4 MW | 205.9 MW |
IT load = kW per rack × racks ÷ 1,000. Facility load = IT load × PUE. 1.56 is the 2024 industry average PUE (Uptime Institute). 1.2 is shown as a modern liquid-cooled design case. Add N+1 or N+2 redundancy on top. Sources: Uptime Institute Global Data Center Survey 2024; Vertiv, GB200 NVL72 reference architecture (up to 132 kW per rack).
For rack-by-rack benchmarks by workload, see our kW per rack benchmarks guide.
Worked example: sizing on-site generation for a 1,000-rack AI hall
A 1,000-rack hall of 132 kW liquid-cooled racks is a 132 MW IT load. At a PUE of 1.2 the facility draws about 158 MW. In 45 MW blocks, that is four units running, plus one more for N+1, before allowing for site derating from heat and altitude. (All of this is arithmetic from the table. It is not a USP&E performance claim.)
New USP&E FX-45 45MW Modular Gas Turbine for the Hyperscale Data Center sector in the USA. Delivery slots for 2028 to 2030. Reserve an FX-45 slot.
The Energy Challenge in the AI Sector: What the Data Shows
AI and data center power demand is now one of the fastest-growing segments of global electricity consumption. According to Lawrence Berkeley National Laboratory’s 2024 report for the U.S. Department of Energy, US data centers used 176 TWh of electricity in 2023, about 4.4% of US consumption, and could use 325 to 580 TWh by 2028, or 6.7% to 12% of the total. The International Energy Agency projects that global data center electricity consumption could reach 1,000 TWh annually by 2026, more than doubling in three years.
The driver behind this surge is the rapid deployment of large language models (LLMs) and generative AI infrastructure. Training a single frontier AI model can require 20MW to 50MW running continuously for weeks. Inference workloads at scale, where models respond to millions of user queries per second, demand equally consistent, stable, high-quality power delivery.
Table 1: AI Data Center Power Requirements by Facility Type (2024 to 2026)
|
Facility Type |
Typical Power Draw |
Annual Energy Consumption |
Key Power Quality Requirement |
|
Edge AI / Enterprise AI |
1MW to 10MW |
8 to 88 GWh/year |
High availability, N+1 redundancy |
|
Colocation / Mid-Scale Data Center |
10MW to 50MW |
88 to 438 GWh/year |
Stable voltage, PUE below 1.4 |
|
Hyperscale AI Campus |
50MW to 500MW |
438 GWh to 4.4 TWh/year |
99.999% uptime, behind-the-meter generation |
|
AI Training Supercluster |
500MW to 1,000MW+ |
4.4 to 8.8 TWh+/year |
Dedicated captive generation, grid bypass |
Sources: Lawrence Berkeley National Laboratory 2024 United States Data Center Energy Usage Report; International Energy Agency Electricity 2024 Report.
The grid interconnection queue in the United States is severely congested. Lawrence Berkeley National Laboratory reports that as of 2023, over 2,600 GW of proposed generation and storage projects were waiting for grid interconnection approvals, with median wait times exceeding 5 years. For data center developers who need power in 12 to 36 months, grid-dependent strategies carry unacceptable development risk.
Key Drivers of AI Data Center Power Requirements: Why Now Is the Critical Window
Five converging forces are making AI data center power requirements the defining infrastructure challenge of this decade:
- The Hyperscaler Arms Race. Microsoft, Google, Amazon, Meta, and their competitors have announced combined AI infrastructure investment exceeding $300 billion for 2024 and 2025. Each campus-scale deployment represents 100MW to 500MW of new power demand. This demand is concentrated in regions where grid capacity is already constrained, including Northern Virginia, Arizona, Texas, and the Pacific Northwest.
- GPU Cluster Density. Modern AI accelerators, including NVIDIA H100 and B200 GPU clusters, draw significantly more power per rack than previous-generation compute. A single rack of AI accelerators can consume 30kW to 120kW. A 100,000-GPU cluster can require 300MW to 500MW of sustained, stable power delivery.
- Grid Interconnection Delays. New transmission capacity construction in the U.S. requires 10 to 15 years from planning to energization. Utility substations capable of serving 100MW+ loads may take 3 to 7 years to upgrade. Behind-the-meter generation using natural gas turbines or gas-fired reciprocating engines eliminates grid dependency entirely.
- Energy Security and Price Volatility. Data center operators are seeking long-term fuel price stability. Natural gas contracts for behind-the-meter generation offer predictable OpEx versus volatile retail electricity tariffs. Operators running 500MW facilities are exposed to enormous commodity price risk on the public grid.
- Regulatory and ESG Pressure. The S. Department of Energy is actively developing frameworks for data center energy efficiency and clean power procurement. Many hyperscalers have committed to 24/7 carbon-free energy. Hybrid systems combining natural gas turbines with solar generation and battery storage are emerging as the primary ESG compliance pathway.
Table 2: Behind-the-Meter vs. Grid Power for AI Data Center Power Requirements
|
Factor |
Grid-Dependent Power |
Behind-the-Meter Gas Turbine |
Hybrid Gas + Solar + Storage |
|
Interconnection Timeline |
3 to 15+ years |
Typically 12 to 36 months where equipment is already secured. New OEM gas turbines are now 4 to 7 years. |
18 to 48 months |
|
Power Price Certainty |
Low (tariff-dependent) |
High (fuel contract) |
High (fuel + PPA) |
|
Uptime Guarantee |
Utility SLA (varies) |
98% to 99.9% with O&M contract |
98% to 99.9% with O&M |
|
Fuel Flexibility |
Grid mix (no control) |
Natural gas or dual-fuel |
Gas, solar, and battery |
|
Regulatory Risk |
High (interconnection approval) |
Moderate (local permits) |
Moderate to Low |
Section 4: EPC and Power Solutions for AI Data Centers: A Technical and Commercial Overview
When a data center developer or hyperscaler determines that grid power is unavailable or unreliable within their required timeline, the project moves to captive or behind-the-meter power generation. The EPC pathway for this solution involves six major workstreams: load sizing and feasibility study, equipment selection, civil engineering, procurement of balance-of-plant components, installation and commissioning, and long-term operations and maintenance. USP&E delivers all six under a single contract through our integrated power plant engineering and EPC construction capabilities.
Load Sizing and Feasibility for AI Data Center Power Requirements
The first question any power EPC contractor must answer is: how much power does this facility actually need? AI data center power requirements are not static. Facilities must be sized for peak demand, not average demand, with appropriate N+1 or N+2 redundancy for mission-critical systems. A 100MW IT load facility typically requires 120MW to 150MW of installed generation capacity to accommodate cooling overhead, power conversion losses, and standby redundancy.
A competent feasibility study for a data center power plant project covers the following workstreams:
- Site-specific load analysis and demand forecasting for current and planned compute phases
- Fuel supply confirmation and specification, covering pipeline gas, LNG, and dual-fuel options
- Grid interconnection study for hybrid approaches that supplement captive generation
- Equipment selection across gas turbines, gas-fired reciprocating engines, and hybrid systems
- CapEx and OpEx modelling across a 10 to 25 year project life with multiple fuel price scenarios
- Environmental permitting assessment and local authority engagement strategy
Fuel Type Comparison for AI Data Center Power Requirements
|
Fuel Type |
OpEx Level |
Lead Time to Power |
Best Application |
|
Natural Gas Turbine (aeroderivative) |
Low to Medium |
12 to 24 months |
50MW to 500MW AI campus |
|
Natural Gas Turbine (industrial frame) |
Low |
18 to 36 months |
100MW to 1GW base load |
|
Gas Reciprocating Engine |
Medium |
12 to 24 months |
10MW to 100MW, high efficiency |
|
HFO Reciprocating Engine |
Medium to High |
18 to 30 months |
Where gas unavailable; not preferred for data centers |
|
Hybrid Gas + Solar + Battery |
Low to Medium |
18 to 48 months |
ESG-committed operators, dual-fuel hedge |
For AI data center applications in North America and the Middle East, aeroderivative gas turbines, particularly the GE LM2500, GE LM6000, and GE TM2500 mobile turbine series, represent the preferred fast-track solution. These units offer 20MW to 50MW per unit, can be mobilized within 12 to 18 months, and deliver the power quality and stability that GPU-intensive AI workloads require. USP&E maintains direct access to over 1,200MW of aeroderivative and industrial frame natural gas turbines in our global inventory. For US hyperscale campuses, see the New USP&E FX-45 45MW Modular Gas Turbine for the Hyperscale Data Center sector in the USA.
For operators seeking an integrated platform to monitor and optimize captive power generation, USP&E’s SmartPower AI platform provides real-time performance data, predictive maintenance alerts, and fuel optimization analytics. For long-term generation management, our operations and maintenance team supports plants backed by 25,000 MW contracted since 2002 with contractual uptime guarantees.
Data center developers pursuing a hybrid approach combining gas with solar and storage should review USP&E’s hybrid power systems capability, which covers the full engineering and procurement scope for solar-gas-battery configurations.
Case Studies: Proven Results for Data Center and Industrial Power Projects
USP&E has delivered captive generation and behind-the-meter power solutions for industrial, mining, and utility clients across 45+ countries. While specific hyperscale data center client details remain confidential under NDA agreements, the following project references demonstrate equivalent execution capability for large-scale, fast-track power generation:
United States Gas Turbine Projects (2024 to 2025): USP&E has active gas turbine supply, EPC, and O&M engagements in the United States serving clients in the data center, oil and gas, and industrial power sectors. Our U.S.-based engineering team manages procurement, logistics, and full EPC coordination from our North American office with the same systems and standards applied to our international project portfolio.
Saudi Arabia Industrial Power (2024 to 2025): USP&E is currently engaged in power generation projects in Saudi Arabia supporting Vision 2030 industrial development, including large-scale industrial campuses requiring the same load-sizing, fuel supply engineering, and captive generation methodology applicable to hyperscale AI data centers.
Siemens SGT-400 Procurement Case Study: USP&E’s documented case study on a Siemens aeroderivative gas turbine procurement project demonstrates how our engineering team identified and secured surplus assets. This procurement methodology directly applies to data center developers seeking to control CapEx on behind-the-meter generation assets. The same approach reduces equipment lead times by 12 to 24 months versus ordering new equipment from the OEM.
For complete project references, scope of supply documentation, and client contact details, visit the USP&E project portfolio and client case studies and references pages.
How to Select the Right EPC Partner for AI Data Center Power Requirements: 10 Critical Criteria
- Proven baseload experience, not just standby. AI data centers require 24/7 baseload power at 90%+ capacity factor. Ensure your EPC contractor has references for continuous-duty baseload facilities, not emergency backup generator installations. The engineering, fuel management, and O&M requirements are entirely different.
- Gas turbine procurement and engineering expertise. The best data center power solutions involve aeroderivative or industrial frame gas turbines from GE, Siemens, and Solar Turbines. Your EPC must have demonstrated technical capability with these OEM equipment types and access to their service and spare parts ecosystems.
- Direct access to surplus and new-surplus equipment inventory. Lead times for new gas turbines from OEMs can reach 36 to 60 months. An EPC contractor with direct access to verified surplus assets reduces lead time to 12 to 24 months and can cut CapEx by 20% to 40% versus OEM list pricing.
- Integrated O&M capability. Selecting separate EPC and O&M providers introduces coordination risk and accountability gaps. A single contractor delivering both reduces handover failures and ensures that the party who built the plant is accountable for its long-term performance.
- OFAC and FCPA compliance record. For U.S.-based data center developers and their international investors, working with an OFAC and Foreign Corrupt Practices Act (FCPA) compliant contractor is non-negotiable. Request written compliance documentation and a reference to the contractor’s compliance officer before signing.
- ISO certification in quality and safety management. ISO 9001:2015 (quality management) and ISO 45001:2018 (occupational health and safety management) are baseline certifications for any credible EPC contractor in 2026. Request the actual certificates, not a claim of compliance.
- Financial stability and bonding capacity. Your EPC contractor must demonstrate financial stability, bonding capacity, and the ability to place deposits on long-lead equipment without compromising project cash flow.
- Fast-track execution capability with documented references. Data center developers operate on aggressive timelines. Ask your EPC contractor for documented examples of fast-track installations defined as fully commissioned power plants delivered within 18 months of contract signature. Ask for the specific project name, location, MW capacity, and client contact.
- Fuel flexibility and hybrid configuration experience. AI data center operators face ESG pressure to reduce carbon intensity over the life of a facility. An EPC with experience in dual-fuel gas and diesel turbines, and hybrid gas plus solar configurations, provides superior long-term optionality as regulatory and investor requirements evolve.
- Zero legal disputes and transparent references. In 24+ years of operation, 150+ completed projects, and engagements across 45+ countries, USP&E has not had a single lawsuit filed against us by a client or partner. Request a full reference list from any EPC contractor you are evaluating and verify independently through direct client contact before awarding any contract.
Frequently Asked Questions About AI Data Center Power Requirements
What are data center power requirements?
Data center power requirements are the total electrical demand of a facility: IT load, cooling, power conversion losses and the redundancy margin (N+1 or N+2). They are stated in MW for the campus and in kW per rack for the IT floor. Accurate sizing comes from an IT load study before equipment is ordered.
What are AI power requirements per rack?
Most racks in today's data centers draw under 10 kW; the 2024 Uptime Institute survey put the average at about 8 kW. Liquid-cooled GPU racks for AI training are far denser: reference designs for NVIDIA GB200 NVL72 racks support up to about 132 kW per rack.
How many MW does a 1,000-rack AI data center need?
At 132 kW per rack, 1,000 racks are a 132 MW IT load. With a PUE of 1.2 the facility draws about 158 MW, before N+1 or N+2 redundancy is added. The same hall at 30 kW per rack needs 30 MW of IT load, or about 36 MW at PUE 1.2.
How do you convert kW per rack to MW for a data center?
Multiply kW per rack by the number of racks and divide by 1,000 to get IT load in MW. Multiply by the facility's PUE to include cooling and losses, then add the redundancy margin. Generation is sized for peak load, not average draw.
How much electricity do US data centers use?
Lawrence Berkeley National Laboratory estimates US data centers used 176 TWh in 2023, about 4.4% of US electricity. Its 2028 scenarios range from 325 to 580 TWh, or 6.7% to 12% of US consumption, driven mainly by AI servers.
Can behind-the-meter gas turbines meet AI data center power requirements?
Yes. On-site gas turbines avoid long grid interconnection queues and give the operator direct control of fuel and generation. For US hyperscale campuses, USP&E offers the New USP&E FX-45 45MW Modular Gas Turbine for the Hyperscale Data Center sector in the USA, with delivery slots for 2028 to 2030.
Does USP&E deliver data center power plants?
Yes. USP&E supplies gas turbines and reciprocating engines and delivers captive and behind-the-meter power plants under EPC and O&M contracts. USP&E has delivered 150+ power projects in 45+ countries, with 25,000 MW contracted since 2002 and 24+ years of delivery.
Summary: Key Takeaways for AI Data Center Power Requirements Decision-Makers
- AI data center power requirements range from 1MW for small enterprise AI deployments to 1GW or more for next-generation hyperscale AI training superclusters. Accurate load sizing before equipment procurement is non-negotiable.
- Behind-the-meter natural gas generation remains the primary fast-track alternative to the grid queue. New OEM gas turbine lead times are now 4 to 7 years. Projects that use already-secured or surplus equipment can still be delivered materially sooner.
- The all-in installed cost for a behind-the-meter gas turbine power plant ranges from $1.2M to $2.5M per MW, depending on configuration, site conditions, and equipment source.
- Natural gas is the preferred fuel type for AI data center power projects due to price stability, emissions profile, and compatibility with hybrid renewable configurations including solar and battery storage.
- Fast-track EPC delivery of a gas turbine power plant for a data center typically takes 12 to 24 months when verified surplus equipment is available.
- Selecting an EPC contractor with integrated O&M capability, ISO 9001:2015 and ISO 45001:2018 certification, OFAC and FCPA compliance, and a documented clean legal record is critical for protecting a capital investment of $120M to $250M or more.
- AI data center power requirements cannot be met by grid-dependent planning alone in 2026. Developers who move to behind-the-meter solutions now will commission on schedule. Those who wait for utility grid capacity risk delays of 3 to 15 years.
New USP&E FX-45 45MW Modular Gas Turbine for the Hyperscale Data Center sector in the USA. Delivery slots for 2028 to 2030. Reserve an FX-45 slot.
Speak to our engineers about the right solution for your project. Whether you are in early feasibility or ready to mobilize a gas turbine power plant for your data center or hyperscale AI facility, our full complement of mechanical, electrical, process control and implementation engineers across 45+ countries is ready to guide your project to success with speed and without excuses.
USP&E | Powering Possibility. Built for the Frontier.
ISO 9001:2015, ISO 45001:2018, 150+ power projects in 45+ countries, 25,000 MW contracted since 2002
Quick Links:
- Contact USP&E by clicking on this link.
- Request a fast equipment quote
Global Resources
- USP&E's Project Experience Portfolio
- USP&E Case Studies and Client Reference Letters
- USP&E Integrity and Compliance policy
- USP&E's ISO Certifications and Credentials
